Tutorial: Project Workflow (Light) From DB 39.5.14

go to further tutorials


Please note:

  • The following description applies to database versions 39.5.14 and later.

Introduction

Information

  • This tutorial is designed for persons who want to get a first quick and compact glimpse of the operating principles of PLANTA project.
  • This tutorial is a simplified variant of the more detailed and comprehensive Project Workflow, which is designed for PLANTA project users who want to get to know the operating principles and learn to handle the program.

Please note:

  • All exercises are based on the PLANTA demo data. This demo data must be installed beforehand. The master data such as the calendar, resources, users, hourly rates, and so on is already preset in the PLANTA demo data. This tutorial does not cover the definition of master data (for this, see Master Data Entry). It merely shows how to plan a new project in addition to already existing ones, and the effects of this.
  • The screenshots used are merely examples of functions. The screenshot layout may deviate from the program.

Project Creation and Outline Planning by Multi-Project Manager (r41)

Start Program

Information

  • In the PLANTA project standard version, new projects are created by a multi-project manager. The multi-project manager can also make a first outline planning of the new project which he then passes on to the project manager for detailed planning.

Procedure

  • Open the PLANTA client.

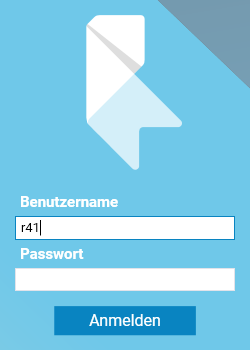

  • Enter “r41” (code of the multi-project manager in the PLANTA demo version) In the upper input field.
    • Demo users do not possess passwords, so no input is required in the second field.
  • Click on the Log in button.

  • A module with an overview of all projects is opened.
  • In this module, the multi-project manager can get a quick overview over the status of the projects (e.g. he can quickly recognize delays in the bar view, receive the project managers’ estimate, etc.)

Create New Project

Task
  • A new IT project with a duration of 6 months is to be created.

Procedure

  • Click on the Multi-Project Management Project planning New Project link in the user menu or click on the New Project button in the Projects module.
  • Enter the Project name for the new project in the module header in the field alongside the ID number, e.g. PR-01.
    • Here, the -Please enter a name- dialog is displayed by default.
  • Define further project data, e.g.:
  • Save by pressing STRG + S or by clicking on the save.png save symbol in the toolbar.
  • Other entries may be added at a later point if required.


Create Schedule

Task
  • Create a schedule on the basis of a project template, e.g. a template for IT projects.

Procedure

  • Open the Schedule module in the Project panel by clicking on the tab of the same name.
  • When you open the Schedule module, the following confirmation prompt is displayed: Is a schedule to be copied in?
  • Confirm the message with Yes.
  • At the bottom of the panel, the Copy Schedule module is opened.
    • If the confirmation prompt is negated accidentally, the Copy Schedule module can be opened by right-clicking on the project header and selecting the command with the same name.
  • Select the project A1-EN Standard plan IT project from the listbox.

  • Start the copy operation by clicking on the Copy Schedule button.
  • The schedule which has been copied to the project is displayed and can be edited.

Edit Schedule (Adjust)

Delete Tasks

Task

  • Delete required tasks, e.g. the Preliminary study task with all subordinate tasks.
Procedure
  • Mark the Preliminary study task (by pressing CTRL and clicking on the task line) in the Schedule module. The child tasks are also marked.

  • Click on the times.png Delete button in the toolbar.
  • A prompt for confirmation is displayed before deletion.
  • Confirm the message with Yes. The marked tasks are deleted.
  • Afterwards, recalculate the project plan by clicking on the calculate_schedule.png Calculate schedule button in the toolbar.

Adjust Task Duration

Task
  • The Create outline concept task is to be completed earlier than specified in the project template. The task duration is supposed to be 10 days.

Procedure

  • Enter the planned duration (e.g. 10 for 10 days) in the Remaining duration field in the Schedule module of the Create outline concept task.


  • Recalculate the project plan by clicking on the calculate_schedule.png Calculate schedule button in the toolbar.
    • In the calculation, the remaining duration of the Outline concept summary task is adjusted to the reduced duration of the Create outline concept task.

Create New Tasks

Task

  • Two more tasks are to be added to the project plan.
    • Coordinate outline concept task under Create outline concept
    • Coordinate DV concept under Create DV concept
Procedure
  • In the Schedule module, right-click on the Create outline concept task and select Insert Task from the context menu.

  • Enter the Task name, here: Coordinate outline concept, and the planned duration (Remaining duration field), e.g. 5 for 5 days, in the task line.


  • Right-click on the Create DV concept task. Select Insert Task from the context menu.
  • Allocate the task name Coordinate DV concept.
  • Scroll to the Milestone column in the middle window.
  • Define the task as a milestone via listbox selection.
    • No duration is to be allocated to the tasks that are defined as milestones or master milestones in PLANTA project.

  • Save.
  • Due to the deletion of previous tasks, the first remaining task Outline concept begins with code "2". The newly added tasks Coordinate outline concept and Coordinate IT concept have not been assigned any codes yet.


  • Press the ButtonPSP14.png Form WBS code button in the project line to update the WBS codes for all tasks of the project and to form codes for new tasks.
  • Result:

Connect Tasks via Links

Task
  • The newly created Coordinate outline concept task and the Coordinate DV concept milestone are to be included in the project by links.
  • This is to be done graphically in the Gantt chart.

Information

  • Links are dependencies between tasks that (can) have an effect on the calculated dates.
  • There can be several links between two tasks. When the schedule is calculated, the most unfavorable relationship takes effect, i.e. the link that causes the latest start date.

Procedure: Connect the Coordinate outline concept task to the Create outline concept and Outline concept completed tasks via links.

  • Step 1: Delete the existing link between the Create outline concept and Outline concept completed tasks.
    • To do so, right-click on the link line and select the Delete links command from the context menu.

  • Step 2: Position the cursor at the end of the bar of the Create outline concept task. The mouse pointer becomes a cross. Drag the task to the beginning of the bar of the Coordinate outline concept task by holding down the left mouse button. Doing so, a connection line between the two bars are displayed. As soon as the target bar is reached, the start position in the source bar and the target position in the target bar are marked by yellow arrows. Release the mouse button.

  • Result:

  • Step 3: Link the bar (end of the bar) of the Coordinate outline concept task to the bar (beginning of the bar) of the Outline concept completed milestone in the same way.

  • Result:

  • When clicking on a bar, incoming links are visualized in red, and outgoing ones are visualized in green.

  • Step 4: Recalculate the schedule by clicking on the calculate_schedule.png Calculate schedule button in the toolbar.
  • Result: The beginning of the Coordinate outline concept task was postponed until after the end of the Create outline concept task. The duration of the Outline concept summary task has changed accordingly.

  • Link the new Coordinate DV concept milestone to the Create IT concept and Create training concept tasks in the same way and click on the calculate_schedule.png Calculate schedule button in the toolbar.

Note

Resource Planning

Task

  • Plan resources and specify an estimated effort:
    • For the Create outline concept task: effort of 80 h for employee Daniela Mueller
    • For the Create DV concept task: Effort of 100 h, employee not defined yet, however, it will be an employee of the IT department, and the Anwendungsentwicklung ("Application Development") department resource is therefore initially planned for the task.
    • The programming effort is planned as EUR 20,000. Resource Fremdleistungen ("External Services") is used for this.

Procedure

  • For the planning of employee Daniela Mueller:
    • Right-click on the Create outline concept task.
    • Select Assign resources from the context menu.
    • Activate the Select checkbox in the line with Daniela Mueller’s name in the dialog module and click on the Assign selected objects button.

  • In the schedule under the Create outline concept, a resource record with the resource Daniela Mueller is created.
  • Assign the Anwendungsentwicklung department to the Create DV concept task in the same way and enter the Remaining effort of 100 h.
  • For scheduling of external services:
    • Right-click on the Programming task.
    • Select Assign cost and revenue resources from the context menu.
    • Activate the Select checkbox in the line named Fremdleistungen and click on the Assign selected objects button.
    • The External goods resource is assigned to the Create outline concept task. Enter the estimated effort of 20,000 (EUR) in the Remaining costs field.
  • Click on the calculate_schedule.png Calculate schedule button in the toolbar. Result: The Total effort or Total costs column is also filled with the appropriate values since it is always calculated by the program and represents the sum of actual and remaining values.


Freeze Planning Status

Task

  • The current planning state of the new IT project is to be frozen so that planning changes which may occur in the course of the project remain controllable.

Details

  • The current planning status of the project is frozen in a status report. At the start of a project it is a regular baseline.

Procedure

  • Open the Status tab in the Project panel in order to switch to the module of the same name.
    • Here, the current status of the project and the existing status reports are displayed.
    • It is a preview module in which new status reports can be created.
  • Click on the Refresh button on the bottom left of the module so that the current project data is displayed in the module.


  • Make estimates and write comments for each factor (costs, dates) if required.
  • Click on the Create baseline button.
  • Confirm the Do you really want to create a baseline? message with Yes.
    • Afterwards, the current status of the project is frozen and the baseline report is created.
    • The created baseline report is displayed in the Status report area with the report status.


Approve Project and Determine Manager

Procedure

  • With the creation of the baseline the planning of the project is completed and the multi-project manager approves the project for further editing and reporting of working hours by deactivating the Locked checkbox in the Attributes/parameters area in the Project Core Data.



  • Furthermore the multi-project manager wants to put the experienced project manager Ronja Koch in charge with the control of the project and define her as the project manager.
  • To do so, he selects Ronja Koch from the listbox in the Manager field in the Project Core Data.


  • Since the creator of a project is automatically set as project manager and as stakeholder of the project at the same time, the following query is displayed when another manager is selected: Would you like to delete the current stakeholder assignment of the manager or would you like to assign the new manager additionally?
  • Confirm this message with Yes.
    • As a result, the new manager is set as a stakeholder in the Stakeholder area and multi-project manager is deleted as a stakeholder.


Hour Reporting by Employee (r1)

Task

  • Project team member (Daniela Mueller) wants to find out about her scheduling and todo items. Additionally, she wants to record the hours she spent working on the project.

Procedure

  • Start a new PLANTA client.
  • Log on with user “r1” (project team member).
  • Daniela Mueller’s Employee Board is opened.
  • In the My Activities module, the project team member can see which projects she is assigned to and which tasks and todo items are to be completed.
  • Activate the Time Recording tab.
    • In the left window, all projects for which the employee is scheduled are displayed.
  • Expand the tree structure of project PR-01.
    • All tasks which Daniela Mueller is supposed to work on are displayed.

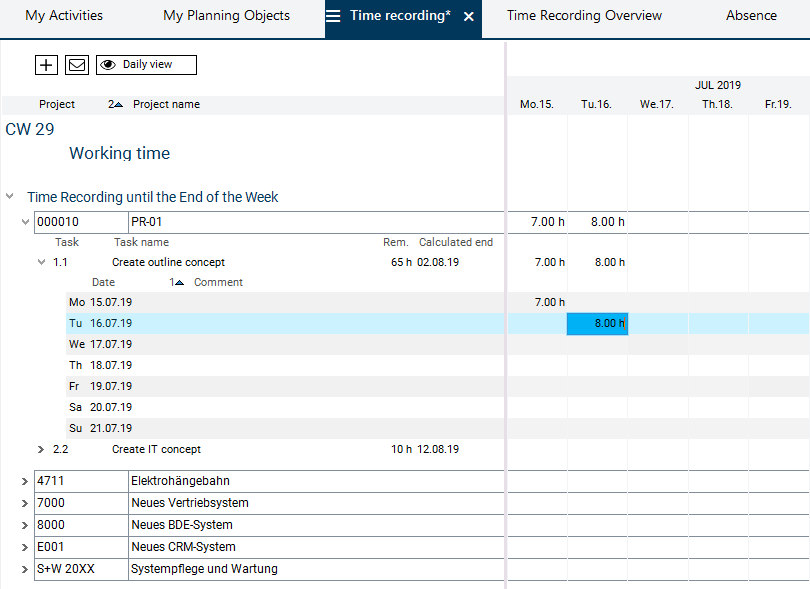

    • In the Remaining field, the employee sees the number of hours she is expected to spend working on the respective task.
  • Click in the field below the required date in the line of the Create outline concept task in the right window.

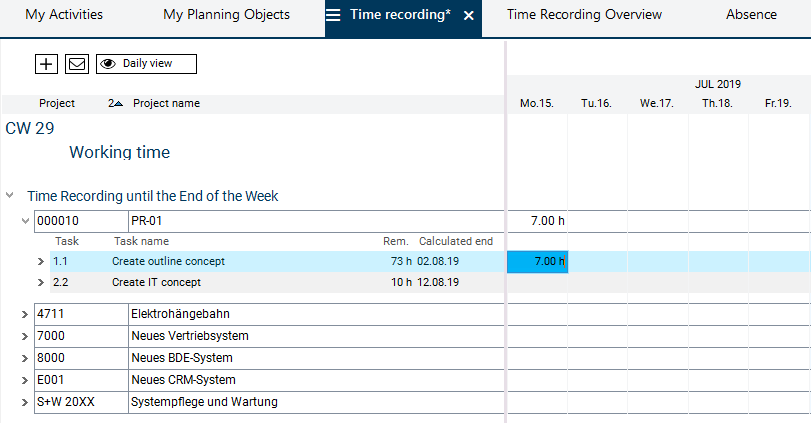

  • Daniela Mueller enters the required amount of time she already worked on the task (actual hours).
    • As a result, the planned value displayed in the Remaining field is reduced automatically so that you can quickly see how many of the planned hours still remain for the completion of the work.

  • Save.
  • Enter hours for all required days in the same way.
  • Expand the task to see the existing load records for all days of the selected week.
    • In the Comment field you can write a comment on the load record.


Transfer of the Reported Hours to the Planning by the Project Manager (r8)

Task

  • Project manager Ronja Koch wants to take a look at the changes in the schedule.

Procedure

  • Start a new PLANTA client.
  • Log on with user “r8” (project manager).
    • The My Planning Objects module is opened automatically.

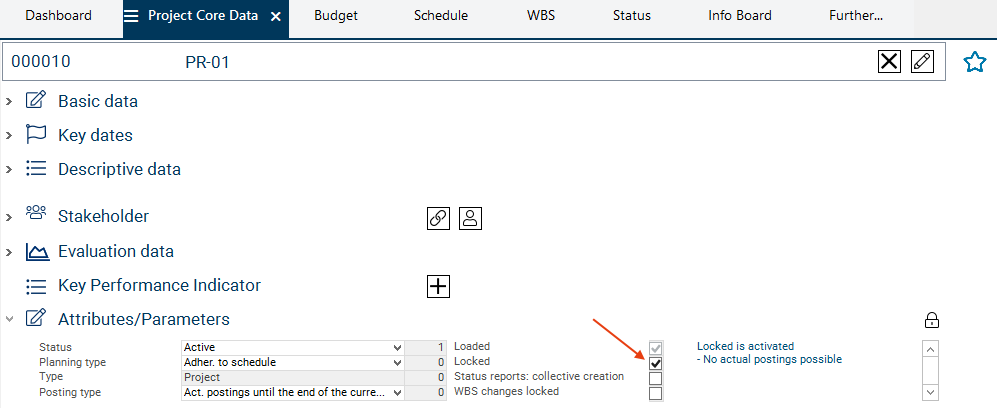

    • In this module, an overview of all planning objects of the project manager is displayed.
  • Click on the ID (here: 000010) of project PR-01.

  • The project panel of project PR-01 is opened.
  • Activate the Schedule tab.
  • Click on the calculate_schedule.png Calculate schedule button in the toolbar.
  • The schedule is refreshed: As a result, the reported hours are copied to the schedule as actual effort. The remaining effort is reduced accordingly. At the same time, the actual start of task and project is set to the date on which the first hours were reported, and the duration of task and project is adjusted.

Topic attachments
I Attachment History Size Date Comment
Pngpng AOBErgebnis1.png r1 13.1 K 2019-07-22 - 06:53
Pngpng AOBErgebnis2.png r1 15.0 K 2019-07-22 - 06:53
Pngpng AOBLoeschen.png r1 11.9 K 2019-07-22 - 06:53
Pngpng AOBTermine.png r1 14.9 K 2019-07-22 - 06:53
Pngpng AOBVerbinden.png r1 12.2 K 2019-07-22 - 06:54
Pngpng AOBVerbinden2.png r1 14.2 K 2019-07-22 - 06:54
Pngpng Baseline.png r1 6.0 K 2019-07-12 - 10:37
Pngpng Baseline1.PNG r1 13.4 K 2019-07-22 - 09:48
Pngpng ButtonPSP14.png r1 0.6 K 2019-07-22 - 06:59
Pngpng DauerRest.png r1 7.8 K 2019-07-22 - 06:54
Pngpng EinplanungenMitte.png r1 10.8 K 2019-07-22 - 10:18
Pngpng EinplanungenNachher1.png r1 9.2 K 2019-07-22 - 10:19
Pngpng EinplanungenNachher2.png r1 8.9 K 2019-07-22 - 10:19
Pngpng EinplanungenVorher.png r1 9.1 K 2019-07-22 - 10:18
Pngpng ErgebnisTR.PNG r1 13.1 K 2019-07-22 - 13:16
Pngpng Login.png r1 6.7 K 2019-07-22 - 06:55
Pngpng LoginEN.png r2 r1 5.9 K 2019-09-27 - 13:05
Pngpng NachPSP.png r1 25.2 K 2019-07-22 - 06:55
Pngpng NeuerMeilenstein.png r1 14.3 K 2019-07-22 - 06:55
Pngpng NeuerVG.png r1 8.5 K 2019-07-22 - 06:55
Pngpng PREntsperren.PNG r2 r1 20.2 K 2020-07-29 - 13:13
Pngpng PREntsperrt.PNG r1 17.1 K 2020-07-29 - 13:13
Pngpng PlanungsobjekteR8.PNG r2 r1 24.1 K 2019-07-22 - 13:18
Pngpng ProjektmanagerAendern.PNG r1 6.3 K 2019-07-22 - 09:57
Pngpng Projektsteckbrief.PNG r1 16.4 K 2019-07-22 - 06:55
Pngpng RessZuordn.PNG r1 7.6 K 2019-07-22 - 06:55
Pngpng Ressourcen.png r1 22.2 K 2019-07-22 - 06:55
Pngpng Stakeholder.png r1 15.7 K 2019-07-22 - 09:57
Pngpng Status-80.png r1 78.2 K 2019-07-22 - 09:48
Pngpng Terminplan-80.png r1 84.0 K 2019-07-22 - 06:56
Pngpng TerminplanKopieren.png r1 5.0 K 2019-07-22 - 06:56
Pngpng VorPSP.png r1 24.9 K 2019-07-22 - 06:56
Pngpng VorgangEinfuegen.png r1 17.7 K 2019-07-22 - 06:56
Pngpng VorgangLoeschen.png r1 10.9 K 2019-07-22 - 06:56
Pngpng Zeiterfassung1.png r2 r1 18.9 K 2020-07-29 - 12:55
Pngpng Zeiterfassung2.png r2 r1 24.3 K 2020-07-29 - 12:55
Pngpng calculate_schedule.png r1 0.6 K 2019-07-22 - 06:59
Pngpng save.png r1 0.5 K 2019-07-22 - 06:58
Pngpng times.png r1 0.5 K 2019-07-22 - 06:58

         PLANTA project










  • Suche in Topic-Namen

  • Suche in Topic-Inhalten
This site is powered by the TWiki collaboration platform Powered by Perl
