The documentation from version 39.5.17 of PLANTA project can be found in the new PLANTA Online Help.

Date, Cost, and Resource Scheduling

Information
  • Below you find general explanations and basic information on the calculation component of the PLANTA software, hereinafter referred to as scheduling.
  • Detailed description of different use cases as well as of the behavior under different configuration settings with examples can be found here. The program depictions used here are based on an older software status and are to be regarded functionally only.
  • In the description of the calculation mechanism for projects, the following abbreviations are used for different project data levels:
    • PR - Project level (DT461)
    • TA - Task level (DT463)
    • TAR - resource assignment level (DT466) (assignment of the resources to tasks)

Data Tables Affected by Scheduling (Excerpt)

Scheduling

Information
  • The term scheduling is used as an umbrella term for two types of scheduling:
    • date/time scheduling and
    • capacity scheduling
  • A scheduling always carries out calculations for the entire network plan.
  • During scheduling, the following work steps are carried out:
    • saving of current project data
    • loading of calendars and resource availability details,
    • unloading of all projects concerned,
    • loading of all required projects,
    • saving of the results
  • The results of scheduling include:

Scheduling: Individual Project Calculation and Replanning

Information
  • In PLANTA project it is possible to carry out scheduling as single project calculation or as a so called replanning.

Single project scheduling

From DB 39.5.14

  • In single project calculation, only one project is calculated (the one selected). This is reasonable if you want to take a quick look at planning results and keep the scheduling runtime at a minimum.
    • If the project to be calculated is a structured project (with subproject) or if the project has external (cross-project) links, then the affected projects are included in the calculation.
    • If several single calculations of different projects are carried out by different users, the user who is first to calculate receives the available capacity of a resource, since the priorities among the projects are ignored in single calculation. To have them considered, you have to carry out a replanning. For this purpose, see the section below.
  • Individual project calculation can be carried out in different modules via the Terminplan.PNG Calculate schedule menu item or automatically forms part of particular functions, like, e.g., Status Report Creation. For details, see the calculation matrix at the end of the topic.

Up to DB 39.5.14

  • In single project calculation, only one project is calculated (the one selected). This is reasonable if you want to take a quick look at planning results and keep the scheduling runtime at a minimum.
    • If the project to be calculated is a structured project (with subproject) or if the project has external (cross-project) links, then the affected projects are included in the calculation.
    • If several single calculations of different projects are carried out by different users, the user who is first to calculate receives the available capacity of a resource, since the priorities among the projects are ignored in single calculation. To have them considered, you have to carry out a replanning. For this purpose, see the section below.
  • Individual project calculation can be carried out in different modules via the Terminplan.PNG Calculate schedule menu item or automatically forms part of particular functions, like, e.g., Status Report Creation. For details, see the calculation matrix at the end of the topic.
  • Replanning

    • Replanning is a special calculation procedure which enables the simultaneous calculation of all active projects under consideration of priorities between projects. I.e. in projects which share the same resources, those with the highest priority are loaded first and those with lower priority receive the remaining capacity of the resources in question.
    • In replanning, all capacity loading of the resource is completely reorganized in the period data table. For this reason, replanning should be carried out on a daily basis. Depending on the respective runtime, it should be carried out before all important resource adjustments or before taking a look at the utilization diagrams.
      • For the daily replaninng PLANTA recommends that you set up the automated procedure. If you have any questions, please contact your PLANTA consultant.
    • Replanning can only be carried out in the Replanning (calculation of all planning objects) module which has been designed especially for this purpose.

    Note

    • The representation of the overload of the planned resources may vary in one and the same module depending on whether you have carried out a single project calculation or replanning. This can also be attributed to the non-consideration or consideration of project priorities.

    Simultaneous Calculation by Several Users
    Information

    From DB 39.5.14

    • During capacity scheduling, no other user can access the same resource capacities to plan them as well. This is automatically prevented by the program.
      • If any of the resources involved is used in the capacity scheduling which is already in progress when the calculation is started, the following message will be displayed: One of your resources is currently being used in the calculation of another project. Please carry out the calculation again in a few seconds.
    • During replanning, no other calculation can be started in general (neither individual project calculation nor other replanning). If you try to carry out replanning or individual project calculation in a session while already replanning in another session, the following message is displayed: NEW A replanning is being carried out at the moment. Please start your calculation at a later point in time.
    • In PLANTA project, running calculations are indicated by two parameters: Calculation active and Calculation indicator.

    From DB 39.5.12

  • During capacity scheduling, no other user can access the same resource capacities to plan them as well. This is automatically prevented by the program.
    • If any of the resources involved is used in the capacity scheduling which is already in progress when the calculation is started, the following message will be displayed: One of your resources is currently being used in the calculation of another project. Please carry out the calculation again in a few seconds.
  • During replanning, no other calculation can be started in general (neither individual project calculation nor other replanning). If you try to carry out replanning or individual project calculation in a session while already replanning in another session, the following message is displayed: A calculation is currently running.
  • In PLANTA project, running calculations are indicated by two parameters: Calculation active and Calculation indicator.
  • From DB 39.5.11

  • During capacity scheduling, no other user can access the same resource capacities to plan them as well. This is automatically prevented by the program.
    • If any of the resources involved is used in the capacity scheduling which is already in progress when the calculation is started, the following message will be displayed: NEW One of your resources is currently being used in the calculation of another project. Please carry out the calculation again in a few seconds.
  • During replanning, no other calculation can be started in general (neither individual project calculation nor other replanning). If you try to carry out replanning or individual project calculation in a session while already replanning in another session, the following message is displayed: A calculation is currently running.
  • In PLANTA project, running calculations are indicated by two parameters: Calculation active and Capacity scheduling indicator.
  • Up to DB 39.5.11

  • During capacity scheduling, no other user can access the same resource capacities to plan them as well. This is automatically prevented by the program.
    • If any of the resources involved is used in the capacity scheduling which is already in progress when the calculation is started, the following message will be displayed: One of the resources required for this capacity scheduling is currently used by another capacity scheduling.
  • During replanning, no other calculation can be started in general (neither individual project calculation nor other replanning). If you try to carry out replanning or individual project calculation in a session while already replanning in another session, the following message is displayed: A calculation is currently running.
  • In PLANTA project, running calculations are indicated by two parameters: Calculation active and Capacity scheduling indicator.
  • Calculation of Successor Dates

    Information

    • The network theory and the practical approach are available for determining the start of a task successor.
    Network theoretical approach
    If the network theory method is used, the successor starts on the same day on which the predecessor ends.
    Practical approach
    The successor does not start before the next day.

    • in PLANTA project
      • tasks with duration > 0 and EA relationship are planned according to the practical approach, i.e. The successor starts on the following working day
      • tasks with duration = 0 (e.g. milestones) and EA relationship are planned in the following way:
        • If the duration of a task = 0, you can define via the Successor task start +1 day model parameter when its successor is supposed to start.
        • If the successor of a task has a duration of = 0, the successor always starts on the same day as the task itself.

    Details

    • Requested dates which fall on non-working days (vacation, sickness) remain as such and are taken into consideration.
    • Start and end dates are also scheduled on non-working days. The duration, however, is still displayed in working days. The resources are loaded on working days.

    Example

    • The TA Requested start is on Sunday, 11/10/2019, a non-working day.
    • Resource Ronja Koch is on vacation from 11/11/2019 to 11/15/2019. It is not scheduled during its vacation.
    • Task A is scheduled on the Requested start
    • Task B starts on the next working day.

    Note for the use of the Active today line:

    • Tasks which
      • have started (have an Actual start)
      • have not been finished yet (have no Actual end)
      • are supposed to end before today
        • have a calculated end date set to today’s date by the scheduling.

    Planning Horizon

    Information
    • Planning horizon describes the period in which the resources are available for planning in projects. The planning horizon of a resource is defined with the Start period and End period parameters in the Resource Data Sheet module.
      • Periods are single days. Explanation: In order to be able to make assessments on the underloading or overloading of the resources, PLANTA must know the availability of resources. This availability is recorded on a daily basis. One day equates to one period.

    Note

    • If there are not enough periods available for planning, this has the following effect on the calculation of the schedule:
    • If a resource is planned beyond the end of his/her planning horizon (i.e. later than the date of its end period), the effects on scheduling results must be considered.
      • If there is no availability for planned resources due to missing periods, scheduling surmises the availability to be unlimited (7 days week)
        • To the BLD load profile, the following applies:
        • the resource is scheduled for 7 days per week.
      • To the CAP load profile, the following applies:
        • the entire remaining load is planned on one day, i.e. the first day after the period.
        • Since the distribution of the remaining hours on the task are done linearly, this leads to different calculations of calc. end dates of the task and the resource assignment.
      • To all other load profiles, the following applies:
        • loading in accordance with the curve definition
    • If you do not want the system to behave in this way, you can proceed as follows:
      • Alternative 1: Prolonging of the planning horizon of the resource in the Resource Data Sheet.
      • Alternative 2: scheduling of the resource using MAN load profile.
    • However, to prevent performance impairment, the planning horizon should not be longer than necessary. The planning horizon can be extended if necessary.
    • However, to prevent performance impairment, the planning horizon should not be longer than necessary. The planning horizon can be extended if necessary.

    Load

    Information

    • Load is the planning of a project in the existing capacity situation. The term 'loading in' means that
      • a load record is created per resource assignment and day for the entire duration of the task.
      • the sum of all loads of a resource per day (utilization) is saved in the period record.
      • the Loaded project data field is set to activated.
    • Loading is automatically a component of scheduling. It cannot be called up separately.

    Loading sequence

    • The loading between projects is based on:
    • The sequence of the tasks within a project structure or within a project is based on:
      • TA Rank
      • PR Priority
        • Cross project links or project structures can cause individual tasks or all tasks of the project with higher priority to be loaded after a project with lower priority. Further information on the influence of cross-project links and structures on the rank, and hence on the loading sequence, can be found here.
      • TA Priority
      • TA Total float
      • TA Planning early = activated
      • TA Planning early = deactivated
      • Technical Task ID

    The traceability of the loading sequence is given by the Sequence parameter. The value stored there is calculated taking all above mentioned factors into account.

    Load and Utilization

    Information
    • When the project is loaded, load records are created per task and day for the resources planned in the project. The planned effort is then allocated to these load records according to the load profile used. These “load values” are saved in the Load data table and can be viewed in the Schedule module as well as in the time recording modules.
    • The sum of all loads of a resource per day is their utilization. It is saved in the Period data table. The utilization of a resource can either be viewed in the Availability (numeric values) or in different utilization modules (e.g. Utilization ) (in graphical form).

    See also: Overview: Load Profiles, Examples and Application Cases of Load Profiles

    Unload

    Information

    • By unloading, a project can be taken out of the current capacity situation.

    Details

    • Unloading is the opposite of loading. The resources that have been loaded are approved again.
    • When unloading,
      • the load records generated by an RS run are deleted (loading records which have been entered manually are retained).
      • the utilization data stored in period records is reduced respectively.
      • calculated dates are emptied on all project levels.
      • the Loaded checkbox is deactivated.
    • Unloading automatically forms part of scheduling. However, if a project is to be taken out of capacity scheduling, it can also be selected separately via the Edit Unload schedule menu item.

    Example

    • A project is in the offer phase and is loaded in for trial purposes to show the additional loads on the resources involved. As long as the project is not an actual order, it should be taken out of the capacity scheduling.

    Procedure

    • Unload the project via the Edit Unload schedule menu item.
    • Remove the planned effort of the resources in order for the project not to be loaded again.

    Further cases for the use of unloading

    • When you create a template project, a capacity scheduling is carried out in the creation phase and the project is calculated in order to check whether the project plan is correct. After the creation of the creation phase, the project must be unloaded and the Status must be set to Template.
    • Projects the status of which is set to = "inactive" or "archive", must be calculated finally and unloaded subsequently.

    Planning Strategies

    Information
    • In PLANTA project, three planning strategies are to be distinguished:
      • Planning with adherence to schedule
        • The loading is done in accordance with the specified dates. Tasks are not moved or extended. If overloads should incur due to the missing capacity, they will be displayed. No capacity adjustment takes place. No float is used.
      • Planning with adherence to total float
        • In case of capacity shortage, a task can be moved within the project float. If sufficient free capacity is available, the task is loaded. If not, the task is loaded at its latest dates (TA Latest start/Latest end). The project end date (PR Requested end or PR Latest end) is not overrun due to capacity shortage.
      • Planning with adherence to capacity
        • Capacity shortage will cause tasks to be extended until sufficient free capacity is available. The PR Requested end date is not taken into consideration. For further information, see the Capacity Adjustment chapter.
    • The planning strategy is defined via the Planning type parameter in the Schedule module.

    See also: Examples and Application Cases for Planning Strategies

    Capacity Adjustment

    Information

    • During capacity adjustment, the resources are planned in accordance with their availability. This may lead to postponements.
    • The settings required for capacity adjustment are:
    • Capacity scheduling uses the earliest and latest dates as key dates for capacity adjustment. However, capacity adjustment recalculates the durations, which may then be shortened or extended.
    • Capacity scheduling attempts to load the resource within the available duration of the Remaining duration (required duration + float) task only up to the Max. load/day value. If this proves to be impossible, the remaining effort will be loaded uniformly throughout the available interval, even if this causes the resources to be overloaded in these periods.

    Details

    • The remaining capacity is relevant for capacity adjustment, i.e. the daily availability of the resource which has not yet been planned. This is calculated as:
    • The remaining capacity is the available capacity the use of which has not yet been planned.

    Example for the calculation of the remaining capacity
    • On 11/18/XX, a team resource has an available capacity of 21,60h.
    • The utilization (i.e. the sum of loads in all projects on that day) is 14.67h
    • If the resource load limit set in the resource data sheet for is 120%, this gives a remaining capacity for this day of:: 21.60 * 1.2 – 14.67 = 11.25h

    Details of how to use the CAP load profile

    • The Max. load/day value is a desired threshold for capacity scheduling. It can be exceeded if necessary, e.g. if duration or requested dates are preset for the respective task.
    • If no Max. load/day has been set, the entire available capacity left is available for planning.
    • The mere exceeding of the Max. load/day limit does not yet represent an overload, as overload is only determined on the basis of the available capacity of a resource. The resource only has overload when the availability is overrun.
    • The capacity scheduling works with the Max. load/day parameter as follows (provided that there are no further restrictions on the resource assignment, like e.g. requested dates):
      • The required duration of the resource assignment used in scheduling is calculated from Remaining effort / Max. load/day.
      • This duration is the starting value for capacity adjustment.

    Examples

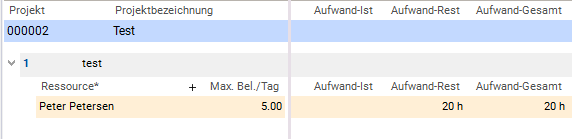

    • Initial situation: No duration is specified on the task.

    • Result: In the calculation of the schedule the available duration of 4d is calculated from: Remaining effort / Max. load/day. The resource is loaded within this duration.

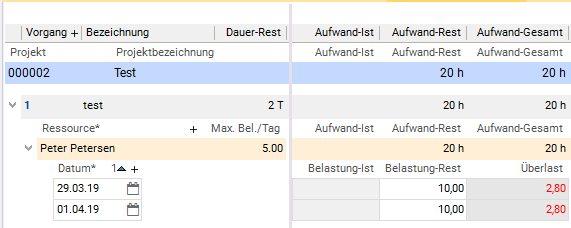

    • Initial situation: Now the duration on the task is preset. It is a duration which is shorter than that calculated from Remaining effort / Max. load/day. I.e. The preset on the task is now more restrictive than the calculation on the task resource.
    • Result: The effort of 20 hours must be allocated across three days. Therefore it is necessary that the max. duration per day be overrun. A maximum of 5h per day is allocated first and subsequently the remaining 5h are allocated evenly across the three days. However, no overload occurs since the available capacity of the resource per day of 7.2h has not yet been overrun.

    • Initial situation: Now an even shorter duration is preset on the task (2d).
    • Result: The effort of 20 hours must be allocated across two days. Therefore it is necessary that the max. duration per day be overrun. A maximum of 5h per day is allocated first and subsequently the remaining 10h are allocated evenly across the two days. Here an overload occurs since the available capacity of the resource per day of 7.2h has now been overrun.

    • Initial situation: With 5d, a duration which is higher than the duration of 4d as calculated from Remaining effort / Max. load/day.
    • Result: The effort of 20h is allocated within the calculated resource duration (4d). The preset on the task (5d) is retained.

    Notes

    • The capacity adjustment for tasks with deactivated Planning early checkbox is done reversely, i.e. starting with the Latest start / Latest end toward the Earliest start / Earliest end tasks.
    • Capacity adjustment is switched off for a resource if both parameters (Adjustment by effort, Effort summarization) are deactivated.
      • Under the following constellations, no capacity adjustment takes place either (even if the two parameters mentioned above are activated):
        • for tasks with BLD resource assignment. They are always planned with adherence to schedule.
        • for tasks with MAN resource assignment. They are always loaded with adherence to schedule.
        • for tasks with requested dates (Requested start and/or Requested end). Task requested dates override the Planning early parameter, i.e.
          • in planning with adherence to schedule and adherence to total float, the task is loaded with adherence to schedule.
          • in planning with adherence to capacity with CAP load profile, the task may be extended if there is an overload.
        • for tasks with activated Fixing parameter.
        • for tasks with Actual start or Actual end If you want the rest of a task that already has an Actual start to be adjusted after all, it must be splitted. This is done by activating the Splitting parameter.
    • Planning With adherence to capacity with Planning early = Unchecked is treated equally by the scheduling as Adherent to total float with Planning early = Unchecked.
      • Background: If this was not the case, planning would start at the end of the planning horizon since this is the latest date in scheduling.

    Factors which Influence Scheduling

    Information

    Dominance Rules within the Task Parameters

    Information

    Example Reason
    TA actual dates override preset links In practice, things often do not work out exactly as planned. A task starts later or earlier than planned. If this has occurred, the schedule change is to be considered in any further planning.
    TA requested dates override the Planning early = N and the capacity adjustment If requested dates are set, the task should be loaded in as well if possible. Only links can prevent this. This also applies when the Fixing = 0 parameter is set. When Fixing = 1, requested dates will even override links.

    Consideration of Different Calendars in Scheduling

    Information
    • PLANTA project enables customers to work with multiple calendars.
    • You can create calendars in the Calendar module.
    • They can be used for multiple purposes in PLANTA project.

    Details

    • System calendar (up to DB 39 releases "company calendar")
    • project calendar,
      • For projects, the calendar is stored in the Calendar parameter (DT461). The project calendar precedes the system calendar This parameter is not used in the Standard but can be integrated in the required modules in customized systems.
    • Task calendar
      • For tasks, the calendar is entered in the Task calendar parameter (DT463) in the Schedule module. By using a task calendar you can, e.g. Make sure that resource loading for tasks in other countries does not start on a local holiday.
    • Link calendar
      • The link calendar is taken into consideration in the interval calculation for subsequent dates. For links, the calendar is entered in the Link calendar parameter (DT465) in the Schedule module.
    • Resource calendar

    Attention

    • A calendar entry on the resource is necessarily required since it is used for the creation of resource periods.
    • If changes are made to the calendar afterwards, they do not have an effect on existing periods of the current resources but only on new periods. If you want changes to take effect on existing resource periods, you have to delete the periods of the respective resources which use the changed calendars and create them anew.
      • Since in PLANTA project some user modules access periods, some, on the other hand, directly access the calendar, this may result in different behavior in modules, if, e.g., the calendar assigned to resources has been changed after the creation of resource periods.

    Interdependence of the calendars

    • Project:
      • If no project calendar has been entered for the project, then the system calendar will be used as the project calendar.
    • Task:
      • If an own calendar is entered on the task, it takes effect regardless of whether other deviating calendars are entered on other objects (system, project, resource).
      • If no own task calendar is entered on the task, the project calendar takes effect. If no project calendar is defined for the project, the system calendar will take effect.
    • Resource assignment
      • On the resource assignment, the respective resource calendar always takes effect.
    • links
      • If a link calendar is entered, it precedes all other calendars in the date determination of links except the task calendar of the successor. I.e. If the task successor has an own task calendar, this calendar overrides the link calendar.
      • If no link calendar is entered, the task calender of the successor precedes if there is one.
        • If there is no task calendar, the resource calendar takes effect if the successor has a resource assignment,
          • if there is no resource assignment, the project calendar takes effect if there is one. If there is no project calendar, the system calendar takes effect.

    Example for the use of a link calendar
    • For the shipping of a turbine, 7 weekdays are estimated. You therefore enter a time interval of 7 days in the link. However, if no link calendar is used, the successor starts 7 working days later, not 7 calendar days. The task is therefore scheduled with a delay.

    • If you use a calendar without work-free days as a Link calendar, the task is scheduled as desired.

    Effect of the calendars on dates and durations

    • Effect of the calendars on scheduled start and end dates
      • A task requested date on a non-working day is not shifted to the next working day.
      • If a TA Requested start or TA Requested end is on a non-working day, the dates calculated from it (e.g. TA Calc. start / TA Calc. end ) moved to the next working day.
      • If a TA Actual start or TA Actual end is on a non-working day, the dates calculated from it (e.g. TA Calc. start / TA Calc. end) moved to the next working day.
      • if a day in the calendar is a non-working day, the task will be extended by the duration of the non-working time;
      • Resources are not scheduled on their non-working days.

    Behavior of the Scheduling in Project Structures

    Information

    • PLANTA project always includes the currently selected project and its subprojects in scheduling. This is done regardless of whether the subprojects are selected and displayed.
      • If the top project is selected, the entire project structure is scheduled by PLANTA project.
      • If a subproject is selected, it is schedules by PLANTA project including its subprojects.

    Principles

    • Key dates are adjusted between main and sub projects, independent of the Structure calculation with adjustment.
    • Durations and effort are summarized from the subproject to the structure task of the parent project.

    Control Data Exchange between Main Project and Subproject

    Information

    Notes

    • If model parameters are changed in the project structures area, the entries in Planned duration, Requested start and Requested end must be checked and corrected if necessary.
    • For cost calculation purposes, you are advised to enter effort and costs only on one level, like e.g. the subproject level. Entry on both structure task and main and subproject level should be avoided.
    • The standard modules do not contain these data items for structure scheduling. If you want to have them displayed, the following data items can be included in the modules individually:
      • DI001123 Structure start , DI001124 Structure end , DI001140 Planned duration/structure , DI001141 Actual duration/structure , DI001142 TA Remaining duration/structure , DI001143 Planned duration/structure DI001143 Planned effort/structure , DI001144 Actual effort/structure , DI001145 Remaining effort/structure , DI001633 Planned costs/structure , DI001634 Actual costs/structure , DI001635 Remaining costs/structure DI001636 Total costs/structure
    • The actual start date is not automatically set for structure tasks with subprojects.

    SF and FF Links for Structure Tasks

    Objective
    • To show the effects of SF and FF links on structure tasks
    Information
    • When carrying out the calculations for project structures, the key dates for the parent task (e.g. TA Earliest start and TA Latest end, depending on the model parameters) are copied to the subproject as its PR Requested start and PR Requested end, so that the subproject can run between these key dates.
    • However, in the case of SF and FF links between structure tasks, their TA Earliest start is not known until the calculations are completed for the subproject, which is why these dates cannot be passed down before that point. There is therefore a chicken and egg problem, which causes some other PM systems to simply ban such links. In PLANTA project, SF and FF relationships between structure tasks are possible. They are taken into account as follows:
      • The TA Requested start of the subproject, the parent task of which is a successor of a SF or FF relationship, arise from:
        • The project start date of the higher level project, if there are no other SS or FS links pointing to this task.
        • The TA Earliest start of the parent task, if it is the successor of an FS or SS link.
      • All tasks which have no successor are moved just far enough so that the SF and FF links are complied with.

    Consideration of the Cross-Project (External) Links in Scheduling

    Information
    • The interlinkage of projects via links results in the generation of a total network plan covering all projects involved. Any projects which have XP links to the project selected by the user are automatically included in the calculations. As a result the own project dates (TA Requested start /Requested end, PR Actual start/Actual end) and project priority are considered.

    Sequence of project calculation

    • In replanning, the cross project links override the the calculation sequence. It may occur that a project with bad priority is calculated earlier due to an existing cross-project links.

    Example

    • Cross-project links between different main projects

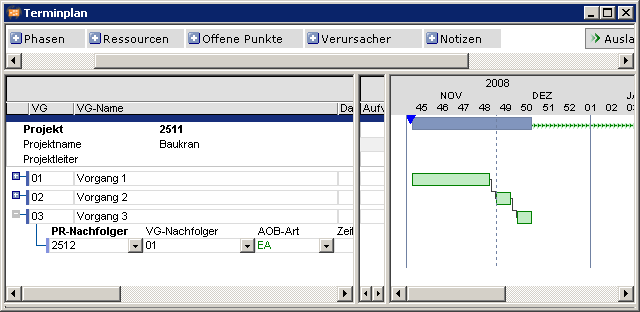

      • There is a cross-project link from task 03 in project 2511 to task 01 in project 2512.

    • Result of scheduling

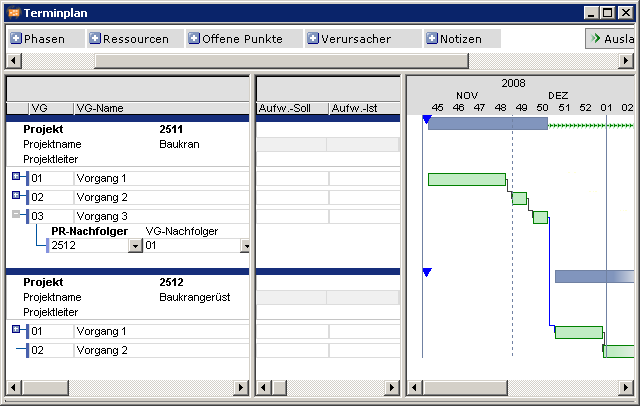

      • TA 01 in Project 2512 cannot take place until after TA 03 in Project 2511 is finished. When the calculations are being performed for Project 2512, Project 2511 will automatically be calculated at the same time. Although the project priority for project 2511 is less urgent, tasks 01 to 03 will be loaded before task 01 from project 2512.

    Determine the Rank of a Task with XP Links

    Information
    • The rank of a task which has a cross-project predecessor is determined as the maximum of its rank within its own project, and the rank of its cross-project predecessor.
    Example
    • Project A has tasks A1, A2, A3, A4, and Project B has tasks B1, B2, B3. Both projects have the same priority.

    • Task (B2) has rank 2 within its project, its cross-project predecessor (A3) has rank 3 within its respective project. As a result, task B2 is given the rank 4 within the Total Network Plan. The rank of its successor will be 5.
    • The load sequence is: A1, B1, A2, A3, A4, B2, B3.

    Example

    • If project B has a less urgent PR priority, then task B1 receives rank 3.

    • Loading sequence, taking into account the project priority: A1, A2, A3, B1, A4, B2, B3.

    Cost Planning/Calculation

    Note

    Calculation Matrix for Dates, Costs, and Budgets

    Module Button Scheduling Cost calculation Budget calculation Calculation of
    benefit and revenues
    Calculation of
    risks and opportunities
    Miscellaneous
    Schedule (Project) Scheduling in the toolbar or the menu item of the same name + + - + +
    Schedule (Program) Scheduling in the toolbar or the menu item of the same name + + - + +
    Budget (Project) Recalculate + + + + -
    Budget (Program) Recalculate + + + - -
    Status (Project) Create baseline, Create status report, Create final report + + + + +
    Status (Program) Create baseline, Create status report, Create final report + - + - +
    Portfolio Update portfolio - + + + +
    Edit Portfolio Period Update portfolio - + + + +
    Status (Portfolio) Create status report           Summarization project status reports
    Replanning Replanning
    Replanning incl. portfolios
    +
    +
    +
    + on PF yearly tranches
    +
    +
    +
    +
    +
    +

    Explanations on the individual calculation types:

    Calculation type Variant Subvariant Component Calculation
    Scheduling

    Manual cost recording model parameter = Checked

        Only dates
      manual cost recording model parameter = Unchecked

        Schedule calculation with costs = 0

      Dates and capacity (loads)
        Schedule calculation with costs model parameter = 1   Dates, capacities (loads) and costs

    Cost calculation, which is carried out in this case and which is part of scheduling, is not to be confused with the standalone cost calculation described below.
    • *Cost calculation* is the ascertainment of costs based on planned effort and on conversion factors in scheduling (DT472) and the subsequent summarization of the costs along the project levels to resource assignment (DT466), task (DT463), and project level (DT461)
    • *Cost calculation* is the summarization of costs ascertained in scheduling to cost type groups
    Cost calculation
      manual cost recording = Checked   Project/program

    Portfolio
    Summarization of the costs os cost type groups per year (DT282) to cost groups per project and project total (DT281), as well as from subprojects to parent projects

    Summarization of the costs from project cost type groups per year (DT282) to portfolio cost type groups per year (DT283)

      manual cost recording = Unchecked   Project/program

    Portfolio
    Summarization of the resource load (DT472) to cost type groups per year (DT282), and subsequently to cost type groups per project and project total (DT281), as well as from subprojects to parent projects

    Summarization of the costs from project cost type groups per year (DT282) to portfolio cost type groups per year (DT283)

    Budget scheduling     Project/program

    Portfolio
    Summarization of the budgets from cost type groups per year (DT282) to cost type groups per project and project total (DT281), as well as from subprojects to parent projects
    Summarization of the budgets from project cost type groups per year (DT282) to portfolio cost type groups per year (DT283)

    Note

    • For detailed information on cost scheduling and cost and budget scheduling, please click here.
    Topic attachments
    I Attachment History Size Date Comment
    Pngpng AOBKalender1.png r1 10.5 K 2019-09-20 - 12:54
    Pngpng AOBKalender2.png r1 10.5 K 2019-09-20 - 12:54
    Gifgif C01500373-DE-00013.gif r1 6.8 K 2019-12-16 - 10:07
    Pngpng GR0110U2-DE.png r2 r1 17.2 K 2020-02-13 - 15:06
    Pngpng GR0110U3-DE.png r2 r1 19.2 K 2020-02-13 - 15:06
    Pngpng GR0110U4-DE.png r2 r1 19.1 K 2020-02-13 - 15:06
    Pngpng GR0110U5-DE.png r3 r2 r1 12.5 K 2020-02-10 - 14:52
    Pngpng GR01500489-DE.png r2 r1 21.5 K 2020-02-10 - 14:46
    Pngpng GR01502828-DE.png r1 11.6 K 2019-09-17 - 10:09
    Pngpng GR01502829-DE.png r1 11.6 K 2019-09-17 - 10:10
    Pngpng GR01502883-DE.png r2 r1 1.7 K 2019-04-05 - 07:45
    Pngpng GR01502884-DE.png r2 r1 1.8 K 2019-04-05 - 07:45
    Pngpng Grundlast.png r1 22.9 K 2013-03-26 - 17:59
    Pngpng KalkAbgl6.PNG r1 11.7 K 2019-03-29 - 13:54
    Pngpng KapAbgl2.PNG r2 r1 7.5 K 2020-02-10 - 14:39
    Pngpng KapAbgl3.PNG r2 r1 7.3 K 2020-02-10 - 14:44
    Pngpng KapAbgl4.PNG r2 r1 9.4 K 2020-02-10 - 14:44
    Pngpng KapAbgl5.PNG r2 r1 7.5 K 2020-02-10 - 14:45
    Pdfpdf L0472-00002579.pdf r1 5032.1 K 2010-08-05 - 13:22
    Pdfpdf TerminRechnung.pdf r1 5032.1 K 2012-05-11 - 10:52
    Pngpng Terminplan.PNG r1 0.8 K 2019-04-04 - 13:48
    Pngpng TerminplanungUrlaub.PNG r1 11.5 K 2019-04-05 - 07:28
    Pngpng WeitereModulparameterAbDB14.PNG r1 15.3 K 2019-03-26 - 09:41
    Pngpng WeitereModulparameterBisDB14.PNG r1 15.3 K 2019-03-26 - 09:40
    Pngpng kapAbgl1.PNG r2 r1 5.7 K 2020-02-10 - 14:38

             PLANTA project

    • Suche in Topic-Namen

    • Suche in Topic-Inhalten
    This site is powered by the TWiki collaboration platform Powered by Perl
