Project Workflow (Tutorial) DB 39.5.13
Please note
- The following workflow applies to database versions starting from 39.5.13.
- The following table contains links to the other versions:
Introduction
Objective
- This tutorial is intended to show first-time users how to use the program and its features on the basis of typical use cases.
Please note
- All exercises are based on the PLANTA demo data. This data must be installed beforehand.
- The master data such as the calendar, resources, users, hourly rates, etc. has already been set up in the demo data. This tutorial does not cover how the master data is defined. (For this, see Master Data Entry). Instead, it is about how to plan a new project in addition to the already existing ones, and to show the effects of this.
- The screenshots used are merely examples of functions. The screenshot layout may deviate from the actual program layout.
Project Management with PLANTA
Information
- The following exercise examples are typical use cases of project management as it is practiced in real situations.
- The following use cases were created for the four most frequently used PM roles:
- Multi-project manager (user R41)
- Project manager (user R8)
- Resource manager (user R43)
- Project staff (user R1)
Details
- PLANTA project additionally enables you to plan and control projects on a process-oriented basis. For further info, see the Process Model Workflow Tutorial.
Start Program
Task
- As every morning, the multi-project manager (Georg Hart) wants to get an overview of his projects and the adherence to the project end dates.
Procedure
- Open the PLANTA project client.
- In the upper input field, enter R41 for the multi-project manager.
- Demo users do not have passwords so that there is no input necessary in the second field.
- Press Log on.
Details
- Further information about the interface can be found here.
Create New Project (R41)
Task
- A sales manager informs the multi-project manager (Georg Hart) about a new IT project with a required duration of 6 months.
- The multi-project manager has to create the project PR-01 and then pass it on to the intended project manager for project planning.
Procedure
- Click on the New Project link in the user menu or press the button of the same name in the Projects module.
- The Project panel with the focused Project Core Data module is opened.
- The ID number for the new project is generated automatically and can be seen in the module header.
- The newly created project is saved automatically. It does not require the Save button or the key combination CTRL + S to be pressed.
- Enter the Project name for the new project in the module header in the field next to the ID, e.g.: PR-01.
- Here, the Please enter a name dialog is output by default.
- Define further project data, e.g.:
- Save.
- Other entries may be added at a later point if required.
- Close the R41 client.
Detailed Planning by Project Manager (R8)
Task
- In theory, the multi-project manager could carry out detailed planning for the project now. However, he wants to delegate this to the experienced project manager (Ronja Koch).
- He asks the project manager to use his standard plan prepared for IT projects.
- The project manager launches the program and immediately starts to plan the project.
Procedure
- Open a new client and log on with user R8.
- The My Planning Objects module is opened automatically.
- In this module, an overview of all planning objects of the project manager is displayed.
- The newly created project PR-01 is displayed. Since the project has not yet been calculated and divided into tasks, the duration is not visualized by a bar in the right window like in other projects, but only by two blue triangles which display the requested project dates.
- Click on the ID of the project PR-01 .
- This takes you to the Project panel that contains further editing options redarding the project.
Assemble Project Team
Task
- The project manager wants to define which employees of the company are going to be involved in her project.
Procedure
- Activate the Project Core Data tab in the Project panel.
- Press the Assign stakeholder button in the Stakeholder area.
- The dialog To which category do you want to assign stakeholders? appears.
- Press the Core team button.
- The Assign Stakeholders to Planning Object module with the selected category opens.
- Select the required stakeholders by activating their respective checkboxes (see the picture below) and press the Assign selected objects button.
- The stakeholders selected will be assigned to the chosen team category (in this case, core team).
- Define the stakeholders' roles using the listbox as in the picture below. Define further parameters if needed.
- The multi-project manager (Georg Hart) should also be assigned to the core team as a stakeholder since he wants to be kept informed about the project.

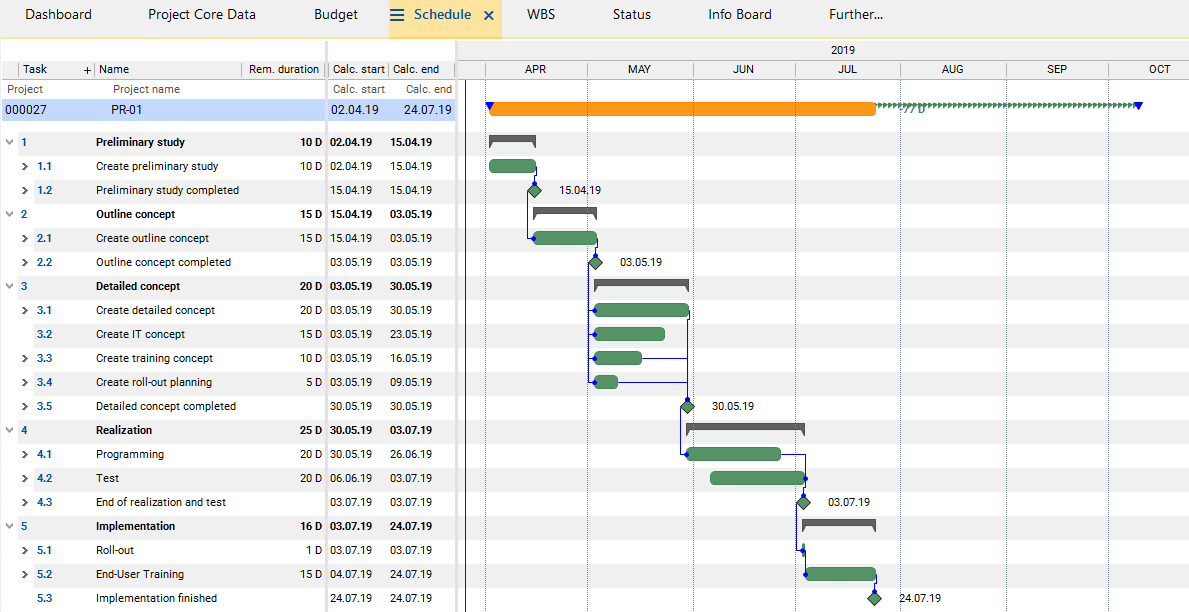

Create Schedule
Task
- The project manager checks whether the requested project end date is realistic. Therefore, she creates a new schedule by copying the IT standard plan to the new project.
Procedure
- Open the Schedule module in the Project panel by clicking on the tab with the same name.
- When opening the Schedule module, the following confirmation prompt is displayed: Is a schedule to be copied in?
- Confirm the message with Yes.
- At the bottom of the panel, the Copy Schedule module is opened.
- If the confirmation prompt is negated accidentally, the Copy Schedule module can be opened by right-clicking on the project header and selecting the command of the same name.
- Select the A1-EN Standard plan IT project from the listbox.
- Start copying by clicking on the Copy schedule button.
- The schedule that was copied into the project is displayed and can be edited.
- The project manager can continue with project planning.
Please note
- In this tutorial, the schedule is a copy of the standard plan.
- As the tasks are already structured in the standard plan template, by copying them the structure is transferred to the new schedule.
- If you create a schedule by creating individual tasks, they are not hierarchically structured. Read about how to structure the tasks in a schedule here.
Edit (Adjust) Schedule
Delete Tasks
Task
- The project manager realizes that not all tasks of the copied schedule are necessary for the newly created project PR-01.
- The Preliminary study task can be deleted. The project manager therefore deletes all tasks that relate to the Preliminary study.
Procedure
- In the Schedule module, mark the Preliminary study task (by pressing CTRL and clicking on the task line). The subordinate tasks are also marked.
- Press the Delete button in the toolbar.
- A prompt for confirmation is displayed before deletion.
- Confirm the message with Yes. The marked tasks are deleted.
- Afterwards, recalculate the project plan by pressing the Calculate schedule button in the toolbar.
Adjust Task Duration
Task
- The project manager realizes that the Create outline concept task has to be completed earlier in this specific project than determined by the project template.
- Consequently, she wants to limit the duration of the task to 10 days.
Procedure
- In the Schedule module, enter the intended duration (e.g. 10 for 10 days) in the Rem. duration field in the Create outline concept record.
- Press the Calculate schedule button in the toolbar.
- The remaining duration of the Outline concept summary task is recalculated to reflect the shortened duration of the Create outline concept task.
Create Tasks
Task
- Two more tasks are to be added to the project plan.
- The project manager wants to insert the task Coordinate outline concept below the record of the Create outline concept task.
- The additional milestone Coordinate IT concept is to be added after Create IT concept.
Procedure
- In the Schedule module, right-click on the Create outline concept task and select Insert Task from the context menu.
- Enter the name (here: Coordinate outline concept) in the task line and the planned duration (e.g. 5 for 5 days) in the Rem. duration field.
- Right-click on the Create IT concept task. Select Insert Task from the context menu.
- Enter the name Coordinate IT concept.
- Scroll to the Milestone column in the middle window.
- Define the task as a milestone via listbox selection.
- Do not assign a duration to any tasks that are defined as milestones or master milestones in PLANTA project.
- Save.
- Press the Generate WBS code button to update the WBS codes for all tasks of the project (due to the deletion of previous tasks, the first task Outline concept begins with code 2) and to form codes for new tasks.
- Press the Calculate schedule button in the toolbar.
- Result:
Connect Tasks by Links
Task
- The newly created Coordinate outline concept task and the Coordinate IT concept milestone are to be included in the project by links.
- This can be carried out graphically in the barchart.
Information
- Links are dependencies between tasks that (can) have an effect on the calculated dates.
- There can be multiple links between two tasks. In the calculation of the schedule, the most unfavorable relationship takes effect, i.e. the link that causes the latest start date.
Procedure: By using links, connect the
Coordinate outline concept task to the
Create outline concept and
Outline concept completed tasks.
- Step 1: Delete the existing link between the Create outline concept and Outline concept completed tasks.
- For this purpose, right-click on the link and select the Delete link command from the context menu.
- Step 2: Position the cursor on the end of the bar of the Create outline concept task. The mouse pointer becomes a cross. Drag the task to the beginning of the bar of the Coordinate outline concept task by holding the left mouse button. A connection line between the two bars appears. As soon as the target bar is reached, the start position in the source bar and the target position in the target bar is marked by yellow arrows. Release the mouse button.
- Step 3: In the same way, link the bar (end of the bar) of the Coordinate outline concept task with the bar (beginning of the bar) of the Outline concept completed milestone.
- When clicking on a bar, incoming links are visualized in red and outgoing ones are visualized in green.
- Step 4: Run the calculation with the Calculate schedule button in the toolbar.
- Result: The beginning of the Create outline concept task was postponed until after the end of the Create outline concept task. The duration of the Outline concept summary task has changed accordingly.
- In the same way, link the new Coordinate outline concept milestone with the Create IT concept and Create training concept tasks and press the Calculate schedule button in the toolbar.
Note
Resource Planning
Task
- The project manager starts thinking about the effort of her new project.
- From experience, she estimates the effort and plans the required resources:
- For the Create outline concept task: 80h effort for employee Daniela Mueller.
- For the Create IT concept task: 100h effort, employee not defined yet, however, it will be an employee of the IT department; the Application Development department resource ("Anwendungsentwicklung") is therefore initially planned for the task.
- The programming effort is planned as EUR 20,000. Resource External Services ("Fremdleistungen") is used for this.
Procedure
- For scheduling the employee Daniela Mueller:
- Right-click on the Create outline concept task.
- Select Insert Resource from the context menu.
- Select resource Daniela Mueller from the listbox and enter the estimated effort of 80 (= 80 hours) in the Remain. effort field.
- For scheduling the IT application development department:
- Right-click on the Create IT concept task.
- Select Insert Resource from the context menu.
- Select resource Application Development ("Anwendungsentwicklung") from the listbox and enter the estimated effort of 100 hours in the Remain. effort field.
- For scheduling external services:
- Right-click on the Programming task.
- Select Insert Revenue or cost resource from the context menu.
- Select the cost resource External Services ("Fremdleistungen") from the listbox and enter the estimated costs of EUR 20,000 in the Remain. costs field.
- Press the Calculate schedule button in the toolbar. Result:
Task
- The project manager wants to know whether one of the staff resources has to do overtime as a result of her resource assignments. She checks the result of the planning.
Procedure
- In the middle window, scroll to the right until the Overload column appears.
- If a resource is overloaded, the overload is displayed in the Overload column in red font. If there are no entries, the resource can perform the work without overload.
- Right-click on the resource name record and select the Display Utilization context menu command to display further information on the capacity utilization of this particular resource in all projects. The Utilization with Cause module appears.
Task
- The project manager wants to reduce the resources' overload.
- Overload can be reduced by using any free capacity of the resources. In this case, the task is postponed until sufficient free capacity is available. Pay attention to the project end date: It can be overrun.
Procedure
- In the Schedule module, on the project level in window 2 in the Planning type field, select the Adher. to capacity type from the listbox.
- Press the Calculate schedule button in the toolbar.
- Result: The overload of the resource has disappeared, the duration of the corresponding Create outline concept task has been extended.
- Alternatively, select the planning type Adher. to tot. float ('adherence to total float'). In this case, only free capacity within the float is taken into account to reduce any overload. It does not postpone the project end date.

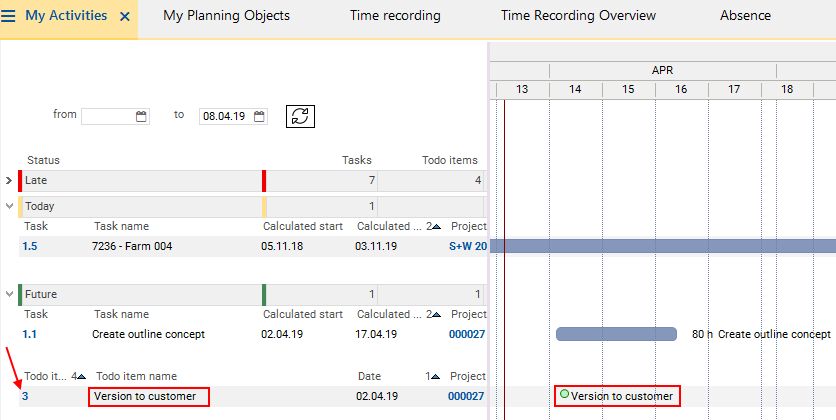

Create Todo Items
Task
- Next week, the employee Daniela Mueller has to send an interim status of the outline concept to the customer.
- The project manager creates a todo item for the Create outline concept task which she names Version to customer.
Procedure
- In the Schedule module, select the With Todo Items module variant from the listbox.
- Right-click on the Create outline concept task and insert the todo item Version to customer via the Insert Todo item context menu command.
- Enter the name of the todo item in the Todo item name field.
- Save.
- As a result, the ID number (Todo item field) of the todo item is generated automatically.
- The Created on field of the todo item is automatically filled with the current date.
- Select Daniela Mueller from the Resource listbox.
- Enter the required completion date for next week in the Date field (or overwrite the current date).
- Save.
- The employee Daniela Mueller will find the todo item on her Employee Board.

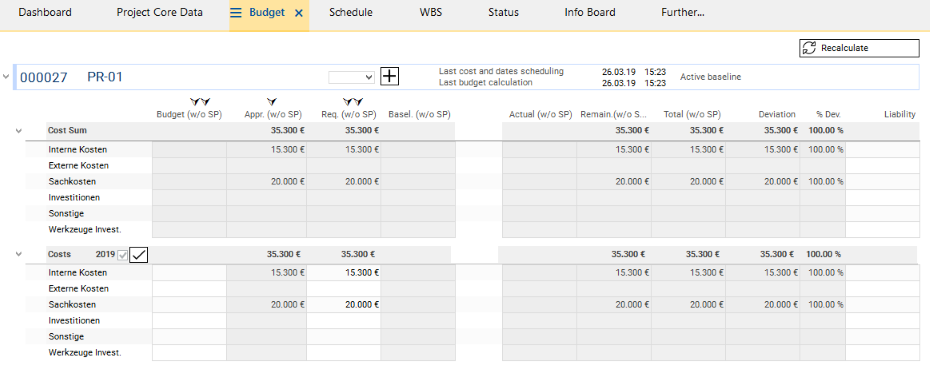

Request Budget
Task
- The project manager wants to view the costs calculated by the program in the course of the resource planning and request the project budget on this basis.
Procedure
- Activate the Budget tab in the tab bar.
- In the Cost area, the costs calculated on basis of the resources planned for the project and their conversion factors are displayed on two levels:
- in the yearly tranche of the current year,
- on project level (here, the values of all yearly tranches are summarized if multiple tranches exist).
- Copy costs calculated on the yearly tranche level from the Remain. (w/o SP) column (remaining costs) to the Req. (w/o SP) column (requested budget).
- W/o SP refers to the values of the selected project only, without consideration of the values of the subprojects if they exist.
- Since the current project has a run time of less than a year, the budget is not divided into multiple yearly tranches. The entire budget is requested for the entire year.
- Save.
Request Approval for Project Execution
Task
- The project manager informs the multi-project manager that project planning is completed. She asks the multi-project manager to approve the project for execution, as the planned start date for the project is in a few days.
Procedure
- In the Project panel, switch to the Project Core Data module.
- In the Stakeholder area, right-click on the record of the multi-project manager Georg Hart and select the Send info context menu command.
- The message window in which a message can be written is opened.
- In the upper field, the dialog -Please enter a subject- appears. Replace it with a suitable subject and enter the text in the field below it.
- Click on the Send button.
- Result: The multi-project manager receives the message via email.
Approve Project for Execution (R41)
Task
- The multi-project manager checks the effort and costs planned by the project manager and approves the project for execution.
Procedure
- Log on again with R41.
- In the Projects module, click on the link on the ID of the PR-01 project in order to switch to the Project panel.
- Activate the Budget tab.
- The multi-project manager sees the budget requested by the project manager for the current project in the Req. (w/o SP) column (requested budget) in the yearly tranche of the current year. He wants to approve it.
- For this purpose, he clicks on the arrow above the Appr. (w/o SP) column (approved budget).
- The values of the Req. (w/o SP) column (requested budget) in the yearly tranche of the current year are automatically transferred to the Appr. (w/o SP) column (approved budget) of the yearly tranche of the current year as well.
- The multi-project manager clicks on the checkbox next to the Costs heading and subsequently on the Recalculate button.
- As a result, the budget in the Appr. (w/o SP) column (approved budget) is approved.
- The checkbox on the left is ticked.
- The column is grayed out, which means that the values of this column cannot be edited.
- The values of the yearly tranche are summarized to the project level.
- Afterwards, the multi-project manager copies the values from the Appr. (w/o SP) column (approved budget) to the Budget (w/o SP) column by clicking on the right arrow above the Budget (w/o SP) column. Subsequently, he saves and clicks on the Recalculate button.
- Subsequently, the multi-project manager switches to the Project Core Data module (activate the corresponding tab) in order to approve the project for implementation:
- Replace the E - New Projects Code by another one, e.g. A Projects.
- Deactivate the Locked checkbox in the Attributes/Parameters area.
- Save.
- In doing so, the project is approved and worked hours can be reported to the project by the employees.
Task
- The multi-project manager wants to let the project manager know that the project has been approved and that project execution can begin.
Information
Freeze Planning Status
Task
- The multi-project manager wants to define the current planning status of the new IT project, so that any changes made over the course of the project can be controlled.
Details
- The current planning status of the project is frozen in a status report.
Procedure
- Switch to the Status tab in the Project panel.
- In this module, the current status of the project and the existing status reports are displayed.
- It is a preview module in which new status reports can be created.
- Click on the Refresh button on the bottom left of the module so that the current project data is displayed in the module.
- Make necessary changes to the Current status area (only estimates and comments possible).
- Click on the Create baseline button.
- If no baseline report exists, the following message is displayed: Do you really want to create the baseline?
- Confirm the message with Yes.
- Afterwards, the current status of the project is frozen and the baseline report is created.
- The created baseline report is displayed in the Status reports area with the Baseline Report status.
Excursion: Compare Planning States
Information
- During the project progress, further planning states can be frozen in status reports. For project controlling, they can then be compared to the current planning status.
Procedure
- Activate the Milestone trend analysis checkbox in the Configure Trend Analysis module for the status reports that are to be compared with the current project status.
- Activate the Deviations tab in the Project panel.
- When opening the Deviations module, the current data and the data from the most recent of the selected status reports are displayed. ( If status reports have already been compared for this project, data of the last compared status report is loaded by default when you open the Deviations module.)
- At the bottom of the module, in the Report selection area, further status reports are offered for selection if they were preselected in the Configure Trend Analysis module.
- Click on the number of the required status report. Data of this report is displayed alongside the current project data and can be compared.
Replan Department to Staff Resources (R43)
Task
- The department manager of the application development department (Thomas Schaefer) wants to distribute to his employees the 100 hours for project PR-01 reserved for his department by the project manager.
Procedure
- Log on with user R43.
- Click on the Resource Planning tab in the Department Board panel.
- When the module is opened, department and individual resources of the department are loaded automatically.
- In the left window, the projects and tasks are listed that the application development department or individual employees of the department are assigned to as resources.
- For project PR-01_'s _Create IT concept task the department's capacity availability is indicated as 100 h.
- Right-click on the Create IT concept task and select Insert resource from the context menu or
- click on the plus icon next to the task name in order to insert an empty record for selecting a resource.
- Select a resource fom the listbox in the Resource name field, e.g. Daniela Mueller.
- All employees of the application development department are displayed in the listbox.
- Enter the effort which is to be distributed, e.g. 10 hours, in the value to be distributed field.
- Press the Distribute effort button at the bottom of the module.
- Confirm the displayed Distribute resource effort? message with Yes.
- Replanning is carried out.
- Result:
- The department planning volume has been reduced to 90 hours.
- 10 hours are now distributed to the employee Daniela Mueller.
Work Reporting by the Project Team Member (R1)
Task
- Project team member Daniela Mueller wants to find out about her scheduling and todo items. Additionally, she wants to record the hours she spent working on the project.
Procedure
- Start a new client.
- Log on with user R1 (project team member).
- The Employee Board opens automatically.
- In the My Activities module, the project team member can see in which projects she is planned in and which tasks and items are to be carried out.
Details
- The period filter is preset by default so that all todo items from the past to the first day of the week after next week are displayed. In order to have a look at individual future tasks, filter criteria have to be changed.
Report Todo Items
Task
- The Version to customer todo item which the project manager created for next week is almost completed. Employee Daniela Mueller wants to enter the degree of completion and link to the corresponding file.
Procedure
- In the My Activities module, click on the link in the Todo item field in the Future area.
- The Todo Item module opens.
- In the % completed field enter 75%.
- Right-click on the Linked file field and select the Insert context menu command.
- Click on the Search button in the Insert hyperlink window.
- Select the required file and click on the Open button.
- Confirm with OK.
- Save.
Record Project Hours Worked
Task
- At the end of the week, the project team member Daniela Mueller wants to record the hours she worked for the Create outline concept task.
Procedure
- Open the Time recording module (tab) in the Project panel.
- In the left window, all projects and tasks for which the employee is scheduled are displayed.
- Expand the tree structure of project PR-01.
- In the right window, in the line of the Create outline concept task, click on the field below the required date.
- Enter the required number of hours.
- Save.
- In the same way, enter hours for other days.
- Expand the tree structure of the Create outline concept task to view the load records of all days of the selected week. Comments can be added to the records in the Comment field.
Remaining Effort Prognosis
Task
- After the project team member has completed the first version of the outline concept and has identified a couple of problems, she fears that the effort for completion may now be higher.
- She wants to inform the project manager about this additional effort.
Procedure
- The employee expects a higher effort for the Create outline concept task than the project manager has planned. She enters her forecast of 90 hours in the Forecast field.
- Subsequently, she clicks on the Send forecast button.
- The Send Info module is opened including an automatically created message.
- The message contains the following data: the sender, as well as actual, remaining, and forecast values for the effort.
- The project manager of the project is automatically entered as the recipient.
- Click on the Send button.
- The project manager will receive the message via email.
Controlling and Replanning by Project Manager (R8)
Copy Actual Hours and Forecasts
Task
- At the beginning of every week, the project manager checks the project progress.
Procedure
- Start a new client.
- Log on with user R8.
- Open the Project panel of project PR-01 by clicking on the ID number of the project in the Projects module.
- Open the Progress module via the Project panel Further... Progress.
- Press the Calculate schedule button in the toolbar so that the posted actual hours are displayed.
- The entered actual and forecast effort of the project team member Daniela Mueller is displayed.
- Click on the Adopt forecasts button.
- Confirm the message No data are marked. All forecasts will be adopted. with OK.
- To avoid adopting all forecasts at once, mark only the records of the forecasts which you want to adopt before clicking the Adopt forecasts button.
- Result: Daniela Mueller's forecast has been transferred to the Rem. effort field and the Forecast field has been emptied.
- Press the Calculate schedule button in the toolbar.
- Change to the Budget module.
- The cost details show additional costs on the basis of additional effort.
- However, the end date is not under threat.
Create Project Status Report
Task
- The monthly project status report is to be created, edited and released by the project manager.
Procedure
- Switch to the Status tab in the Project panel.
- Click on the Refresh button on the bottom left of the module so that the current project data is displayed in the module.
- Make necessary changes to the Current status area (only estimates and comments possible).
- Click on the Create status report button.
- The following message is displayed: Have you updated your estimates and comments?
- If you do not want to make changes, confirm the message with Yes.
- The status report is created and automatically opens in the Status Report module.
- The created status report is displayed in the Status module, Status reports area.
- The Report status is changed to created.
- In order to release the status report, press the Release button in the Status Report module.
- Once released, the status report can no longer be modified.
- Confirm the message with Yes.
- Press the Refresh/Reset button in the toolbar.
- In the Status module, Status reports area, the status report is displayed with the Last released Report status.
Management Analyses (R41)
Project Overviews
Task
- The multi-project manager (Georg Hart) wants to find out which projects are under threat.
Procedure
- Start a new client.
- Log on with user R41.
- In the Projects module, the multi-project manager checks the project buffer (green arrows) or the delay (red bar) which are both displayed behind every project bar.
- The thumb symbols inform about the project manager's personal evaluation regarding the project status.
Task
- For project 4811, the multi-project manager notices a project delay. He wants to have a closer look at the project.
Procedure
- Click on the ID number of the project or on the Edit project context menu command in order to change to the Project panel.
- Here, the multi-project manager can check the data or evaluations of the project via various modules, e.g. Project Core Data or Info Board.
